CSE: NINE  |  OTCQB: VMSXF  |  FSE: KQ9
Projects · Bathurst Mining Camp

The Wedge Project

They Mined 1.5 Million Tonnes. They Never Found The Bottom.

36.08 km²
Land Package
164
Mineral Claims
~1.5 Mt
Mined by Cominco · 1962–68
10,000m
Phase 3 — Drilling Now

Overview

Past-producer credentials — Cominco, approximately 1.5 Mt at 2.88% Cu, mined 1962–68. Every modern phase has extended the system: open at depth, along strike, and on the western flank.

Three phases drilled — every one has extended the system. Phase 3 is underway and a resource estimate is in progress.

Wedge production figures are historical. See Technical Notes.

Click image to enlarge

Every Phase Has Extended The Deposit

Phase 1 · 2024 — Certified Assays ✓
  • WD-24-07: 40.32m @ 1.65% CuEq — incl. 13.12m @ 2.29% CuEq and 5.50m @ 3.25% CuEq
  • WD-24-08: 44.00 m @ 1.34% CuEq — incl. 12.00 m @ 3.73% CuEq (upper zone) and 9.00 m @ 4.57% CuEq
  • WD-24-03: 32.10 m @ 1.58% CuEq — incl. 16.15 m @ 2.60% CuEq and 8.15 m @ 3.61% CuEq
Phase 2 · Fall 2025 — Certified Assays ✓
  • WD-25-01: 22.65m @ 3.83% CuEq — and 17.65m @ 4.33% CuEq · new Au-Ag zone 13.00m @ 1.21 g/t Au, 50.33 g/t Ag
  • WD-25-02: 32.10m @ 2.78% CuEq — incl. 11.52m @ 4.78% CuEq and 6.02m @ 5.64% CuEq · three distinct VMS zones
  • WD-25-2B: 15.00m @ 3.17% CuEq — incl. 6.84m @ 5.99% CuEq · ended in mineralization at 122m, new lens on the western flank
Phase 3 · 2026 — Active Now · Certified Assays ✓
Each Phase Goes Deeper. Each One Finds More.
  • WD-26-07: two zones, 42.85m total mineralization — lower zone 24.00m @ 2.77% CuEq incl. 9.20m @ 4.14% CuEq
  • WD-26-09: 24.55m @ 3.49% CuEq (true width) — incl. 16.50m @ 4.03% CuEq and 6.50m @ 5.22% CuEq
  • WD-26-10: 31.95m @ 2.52% CuEq (true width) — incl. 14.15m @ 3.73% CuEq and 4.15m @ 5.16% CuEq

“Drilling continues to expand the mineralized footprint in the southwest. As with DDH WD-26-07, we see a variation in the distribution of the mineralization, with this hole highlighting increased assay values for Ag, Au, Pb and Zn at depth, further demonstrating the multi-element value of the Wedge.”

— Gary Lohman, B.Sc., P.Geo., VP Exploration & Director

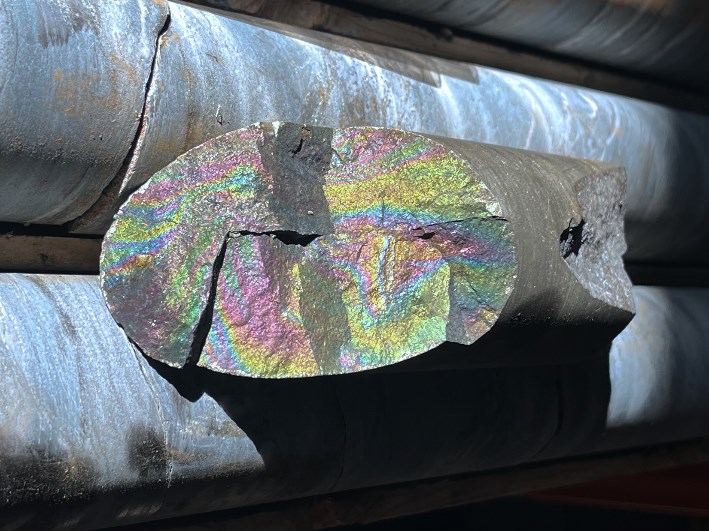

FIGURE 2: Copper Bloom Core Sample — DDH WD-24-07 · 1.65% Cu-Eq over 40.32 m · news release May 16, 2024

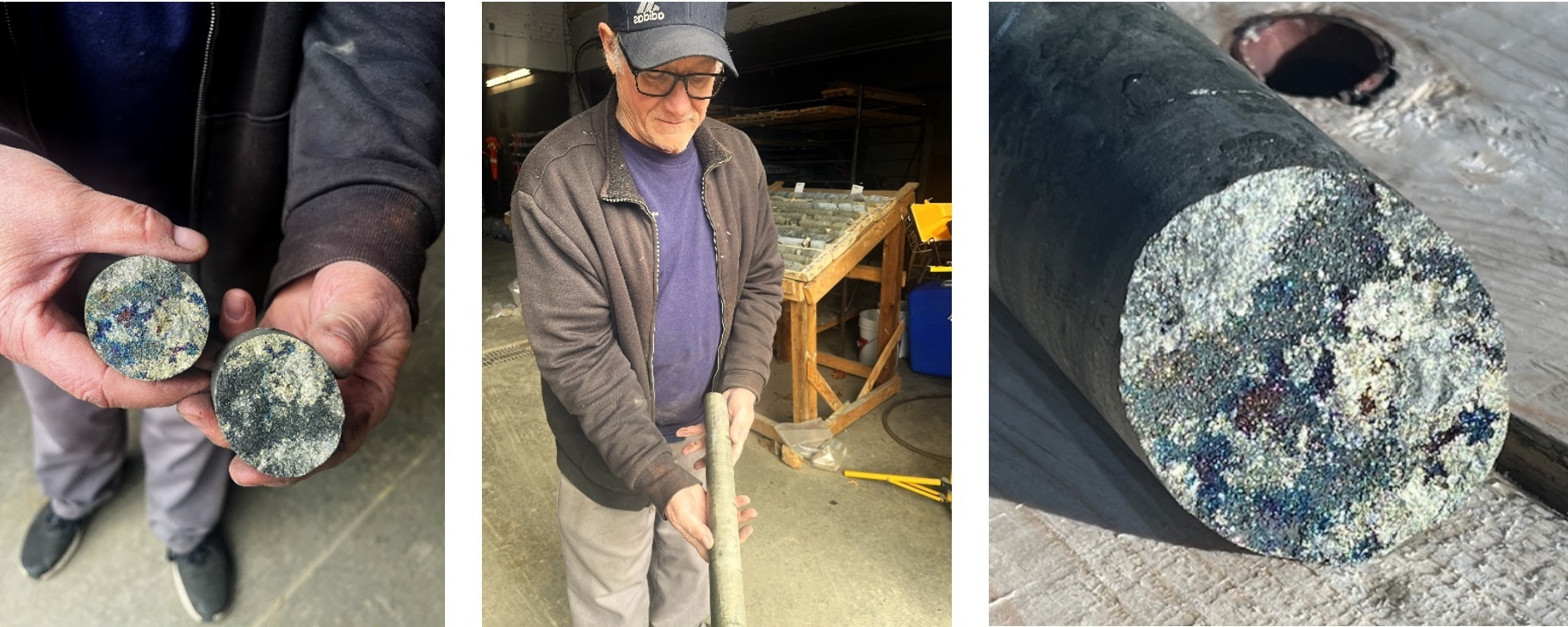

FIGURE 1: Visible Massive Copper Mineralization from Zone 1 & 2 (including Covellite (CuS) & Bornite (Cu₅FeS₄)) — DDH WD-25-02 · news release December 3, 2025

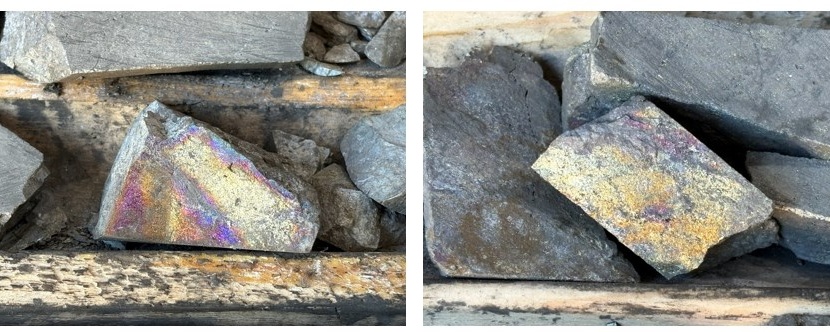

FIGURE 1: Bornite copper samples #396431 (left) and #396432 (right) — DDH WD-26-09 · 3.49% Cu-Eq over 24.55 m, true width · news release August 12, 2026

System open along strike, at depth, and on the western flank.

WD-26-09 and WD-26-10 intervals are true widths; all other intervals are drilled core lengths. Further Phase 3 assays are pending at ALS Global. See Technical Notes.

Selected certified intervals shown. Complete results for each phase are in the tables below.

What 10,000 Meters Buys

Click image to enlarge

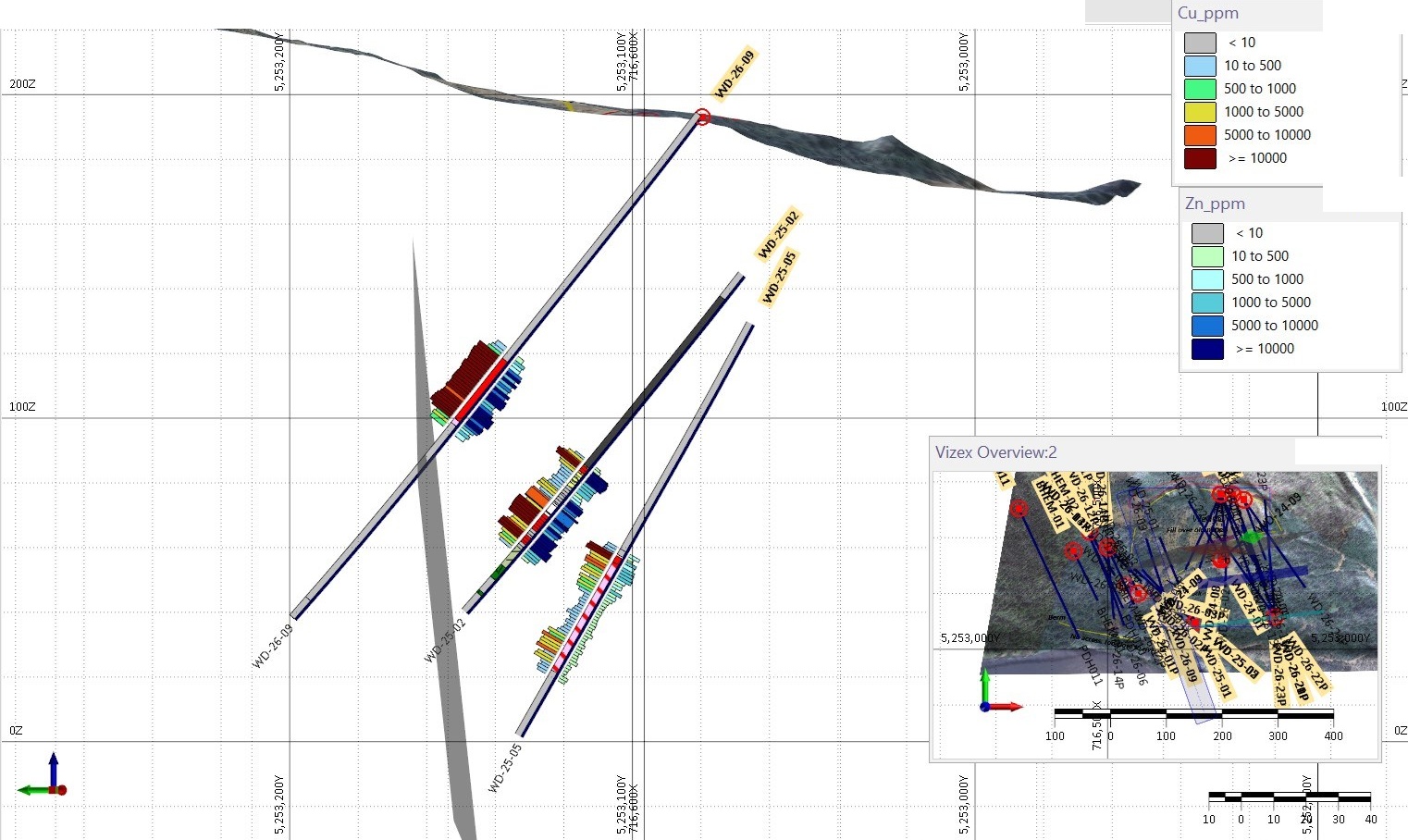

Apex Geoscience cross section — DDH WD-26-09 with WD-25-02 and WD-25-05, copper and zinc grades down hole · news release August 12, 2026 · vertical exaggeration 20×

FOUR HUNTS, ONE PROGRAM:
01
Build Out The Wedge Mine

Increase the mineralized footprint and improve the economics.

02
Chase The New Lens West

WD-25-2B ended in 4.47% Cu; the hole stopped, the mineralization didn’t

03
Go Deeper Than The Mine Ever Did

The expectation is that 60%+ of the deposit remains untouched, based on recent drill testing and 3D modelling

04
Open The Next Fronts: West Wedge And Tribag

Testing six priority targets on the same trend beyond the historic mine, including the West Wedge and Tribag targets.

Every meter feeds the resource. Apex Geoscience is rebuilding the 3D model with Phase 1, 2, 3 and BHEM data — the work that converts three seasons of drilling into a defined, reportable deposit.

Targets shown are conceptual and are not mineral resources. No mineral resource has been estimated on any Company property. See Technical Notes.

The Wedge — Certified Drill Results (NI 43-101)

Bold rows are main intervals; “incl.” rows are sub-intervals of the row above. — = not reported.

Phase 3 · 2026 — To Date
HoleIntervalFromToWidth (m)Cu %Pb %Zn %Ag g/tAu g/tCuEq %
WD-26-07Upper zone 180.1590.009.850.540.522.7423.340.412.10
WD-26-07incl.80.1587.507.350.670.703.5630.390.532.70
WD-26-07incl.80.1585.004.850.870.804.5541.410.773.59
WD-26-07Lower zone 2105.00138.0033.001.460.400.8012.720.202.12
WD-26-07incl.108.00132.0024.001.880.551.0917.100.262.77
WD-26-07incl.122.80132.009.202.700.891.3433.550.444.14
WD-26-09Massive sulphide zone96.80121.3524.551.891.161.8628.850.583.49
WD-26-09incl.104.00120.5016.501.991.612.5236.390.684.03
WD-26-09incl.114.00120.506.502.911.804.3631.920.515.22
WD-26-10Massive sulphide zone109.00140.9531.950.930.572.2324.890.492.52
WD-26-10incl.123.00137.1514.150.981.144.6738.940.683.73
WD-26-10incl.133.00137.154.151.461.426.6445.800.925.16
WD-26-11Upper zone (above void)89.9099.209.302.380.120.1031.980.343.27
WD-26-11incl.95.0099.204.202.920.140.1448.100.404.12
WD-26-11Upper zone (below void)102.90103.400.503.570.210.1129.000.294.37
WD-26-11Lower zone110.50121.2010.701.211.701.4451.860.443.08
WD-26-11incl.114.50119.505.001.502.742.6972.600.574.30
WD-26-14VMS zone107.35121.5014.152.100.964.8542.310.845.09
WD-26-14incl.112.50121.509.002.591.216.8146.670.956.35
WD-26-14incl.115.50121.506.003.341.257.7749.330.987.45
WD-26-15Zone 1114.50122.107.601.561.726.5934.890.684.88
WD-26-15Zone 2128.60129.801.200.701.143.7129.000.5382.89
WD-26-18Upper stringer zone68.50100.0031.500.300.010.101.380.040.40
WD-26-18Massive sulphide lens130.70142.3511.653.231.433.8078.791.407.13
WD-26-18incl.131.70138.406.70—————9.93
WD-26-18incl.133.60138.404.80—————10.46

WD-26-09, -10, -11, -14, -15 and -18 are true widths; WD-26-07 widths are drilled core lengths. WD-26-11’s upper zone is interrupted by a 3.70 m void (interpreted as an old exploration drift). CuEq at 95% recovery. News releases: Aug 12, Aug 25, Aug 27, Sep 21, Sep 24, Oct 15 and Oct 21, 2026.

Seven holes from the 2026 Phase 3 program have returned certified assays to date: WD-26-07, WD-26-09, WD-26-10, WD-26-11, WD-26-14, WD-26-15 and WD-26-18. As of September 21, 2026, 18 holes totalling 4,934.50 m of the planned 10,000 m program had been completed. Drilling continues at the Wedge Mine, a second rig is on site at the Tribag–West Wedge target area, and further assays are pending at ALS Global (news releases September 21 and October 1, 2026).

Phase 2 · Fall 2025
HoleIntervalFromToWidth (m)Cu %Pb %Zn %Ag g/tAu g/tCuEq %
WD-25-01Overall156.05178.7022.650.992.251.6139.520.963.83
WD-25-01incl.161.05178.7017.651.202.622.0542.501.014.33
WD-25-01Au-Ag lens160.05173.0513.000.393.232.4550.331.214.14
WD-25-02Overall138.72170.8232.101.530.471.8114.090.352.78
WD-25-02Horizon 1138.72141.222.503.091.024.8861.571.016.95
WD-25-02Horizon 2150.30165.3215.022.140.521.0011.000.403.19
WD-25-02incl.159.30170.8211.523.200.482.4817.000.434.78
WD-25-02incl.159.30165.326.024.630.270.7912.500.425.64
WD-25-02Horizon 3168.00170.822.822.910.967.1336.650.726.49
WD-25-2BZone 156.0062.006.000.801.482.6645.500.453.20
WD-25-2BZone 2107.00122.0015.002.360.351.297.470.213.17
WD-25-2Bincl.115.16122.006.844.470.752.5814.500.345.99
WD-25-04Upper zone158.35165.757.400.510.020.075.600.150.81
WD-25-04Lower zone184.75198.7514.001.110.060.041.500.081.25
WD-25-04incl.184.75194.7510.001.350.080.041.700.091.51
WD-25-05Overall155.52164.809.281.280.130.1811.070.121.69
WD-25-05incl.155.52161.806.281.780.190.2415.890.162.35
WD-25-05Lower zone187.80192.805.000.510.040.011.200.070.62

True widths per the releases: WD-25-01 (22.65 m), WD-25-02 Horizons 1–3 and the 6.02 m interval, WD-25-2B and WD-25-05; all other widths are drilled core lengths. CuEq at 80% recovery on each release’s pricing date. News releases: Feb 17, Mar 12, Apr 2 and May 5, 2026.

Phase 1 · 2024
HoleIntervalFromToWidth (m)Cu %Pb %Zn %Ag g/tAu g/tCuEq %
WD-24-01Main Cu zone32.5543.6511.101.370.210.2919.020.36—
WD-24-01Upper zone26.7653.1626.40—————0.92
WD-24-02Overall36.74173.05136.310.440.070.543.520.06—
WD-24-02Main Cu zone134.00174.0040.001.320.211.548.840.164—
WD-24-02incl.157.65173.0515.402.030.523.7320.350.34—
WD-24-03Overall37.9070.0032.100.600.701.9817.030.211.58
WD-24-03incl.37.9061.0023.100.800.962.3823.240.272.09
WD-24-03incl.44.8561.0016.151.061.172.9728.640.352.60
WD-24-03incl.44.8553.008.150.952.295.8055.160.653.61
WD-24-04Zone 155.0078.0023.000.170.000.050.050.020.20
WD-24-04Zone 2110.00130.2020.200.691.910.321.910.081.29
WD-24-04incl.115.00127.2612.260.830.100.372.160.091.05
WD-24-04Zone 3136.86147.1010.241.570.742.9926.610.313.08
WD-24-04incl.139.58147.107.521.861.001.1735.500.423.07
WD-24-04Main zone (2 & 3)110.00147.1037.100.810.251.008.50.131.33
WD-24-05Zone 118.3526.358.000.82nil0.543.000.041.04
WD-24-05incl.18.3522.354.001.20nil0.433.500.051.40
WD-24-05Zone 237.5550.0012.450.20nil0.151.200.020.27
WD-24-05Zone 387.00105.0018.000.72nil0.332.200.030.87
WD-24-05incl.88.00101.0013.000.87nil0.452.600.031.06
WD-24-05incl.96.00101.005.001.20nil0.292.000.031.33
WD-24-05Zone 4116.17119.062.890.190.31.47.900.090.83
WD-24-06Mineralized zone68.0078.0010.001.53nil0.817.000.081.88
WD-24-06incl.69.0078.009.001.60nil0.837.400.081.96
WD-24-07Overall116.00156.3240.321.200.180.888.000.121.65
WD-24-07Upper zone123.00138.5015.501.640.080.823.320.081.98
WD-24-07Lower zone143.20156.3213.121.400.451.5519.800.252.29
WD-24-07incl.143.20153.5010.301.700.421.5919.700.222.58
WD-24-07incl.149.00154.505.501.581.023.3939.600.463.25
WD-24-08Overall37.0081.0044.000.470.891.5415.350.181.34
WD-24-08Upper zone37.0049.0012.000.953.064.9548.000.553.73
WD-24-08incl.37.0046.009.000.934.086.4563.350.714.57
WD-24-08incl.38.5049.0010.501.003.305.4049.000.523.94
WD-24-08Lower zone75.0081.006.001.180.050.368.000.091.42

Widths are drilled core lengths; true widths not reported. CuEq as stated in each release (80% recovery); no CuEq was reported for WD-24-01 (main zone) or WD-24-02. News releases: Mar 26, Apr 3, Apr 24, May 16, May 21, May 29 and Jun 24, 2024.

Historic production tonnages and grades sourced to McCutcheon, S.R. and Walker, J.A. (2020), Geoscience Canada, v.47(3), Table 1, published by the Geological Association of Canada. Nine Mile results are drill intersections, not deposit grades, and are not directly comparable to the mined deposits above. Copper equivalent values are calculated on the metal prices and recovery assumptions disclosed in each result’s news release and differ between holes; they are not directly comparable. See Technical Notes and the Company’s filings on SEDAR+.

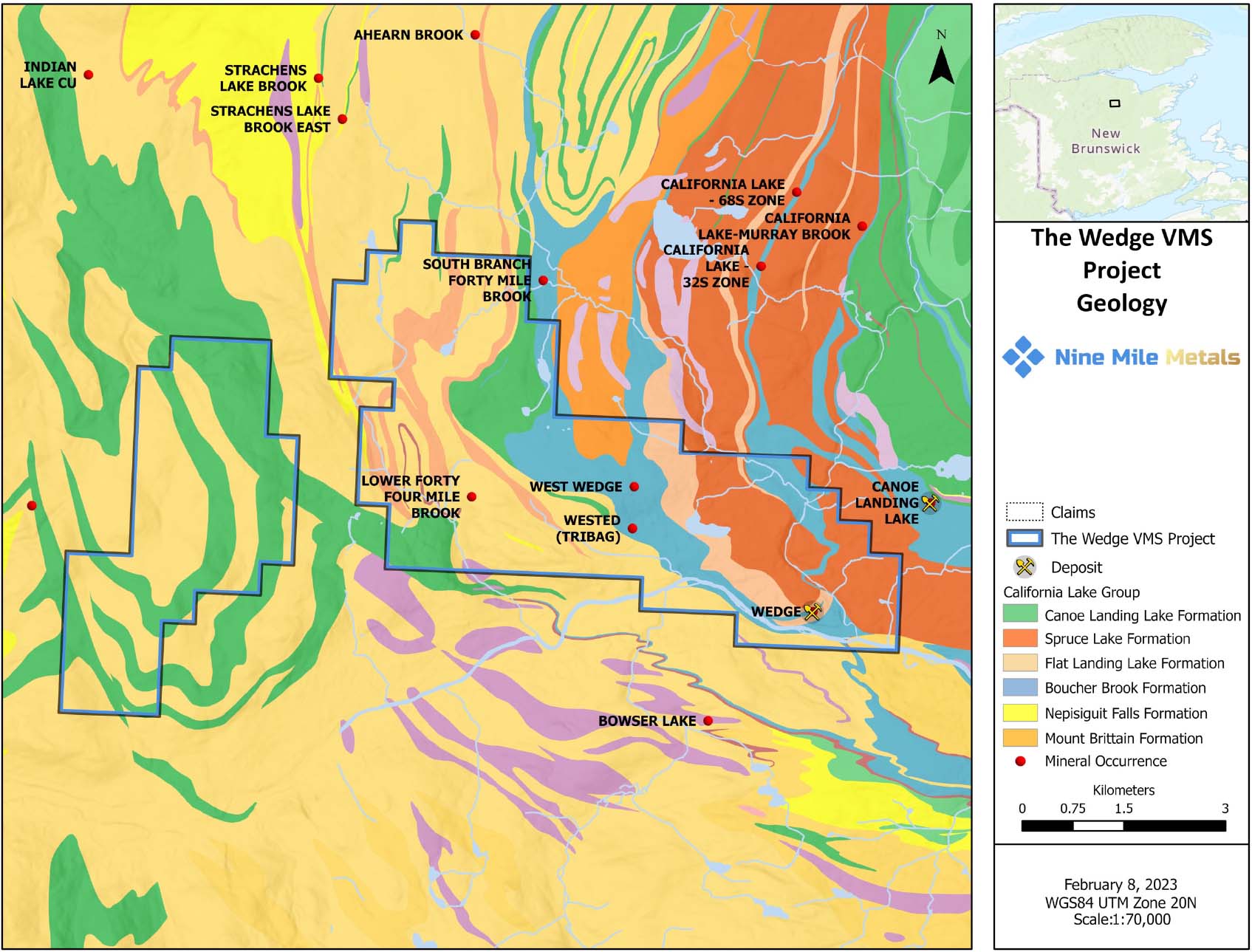

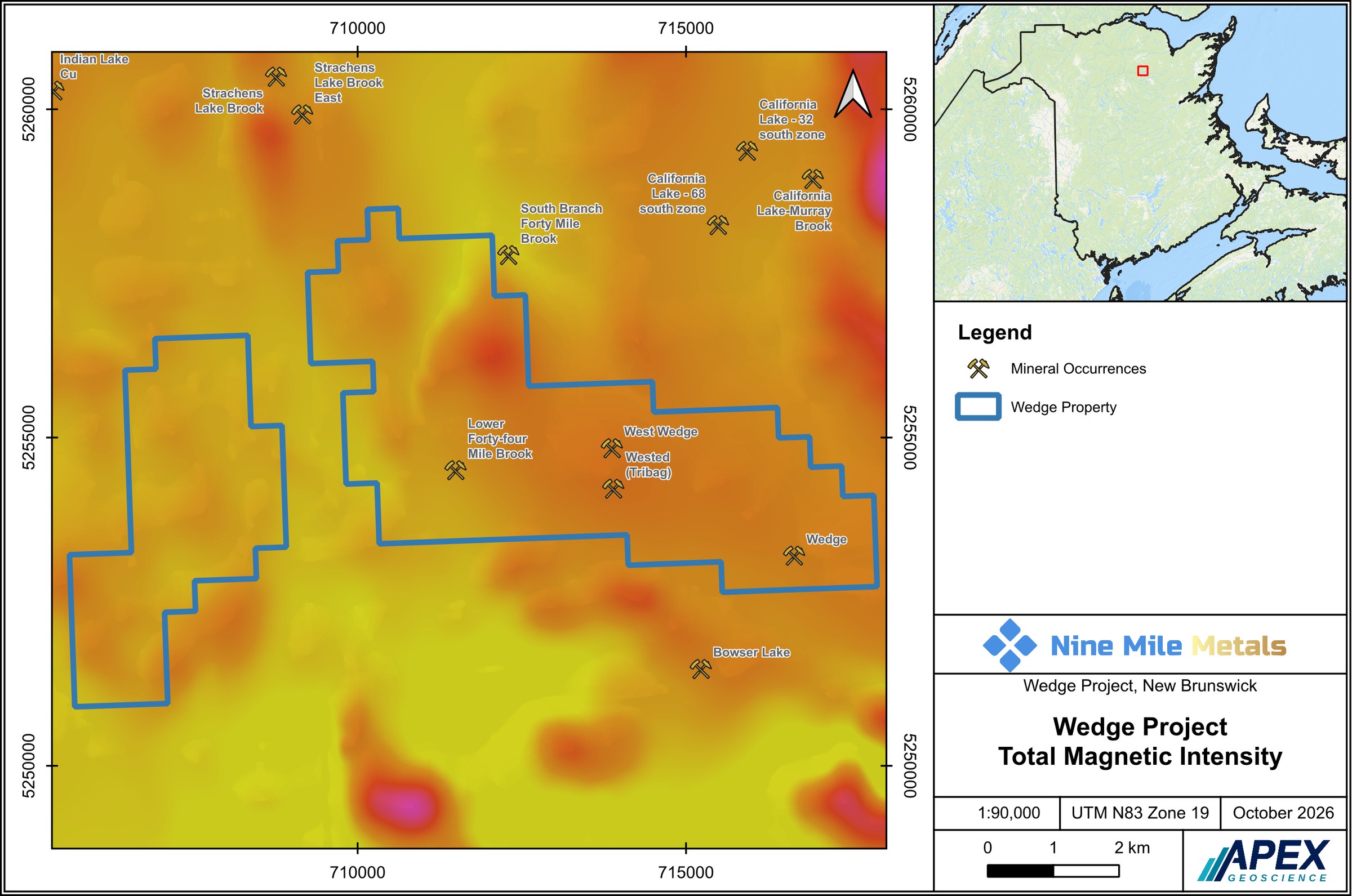

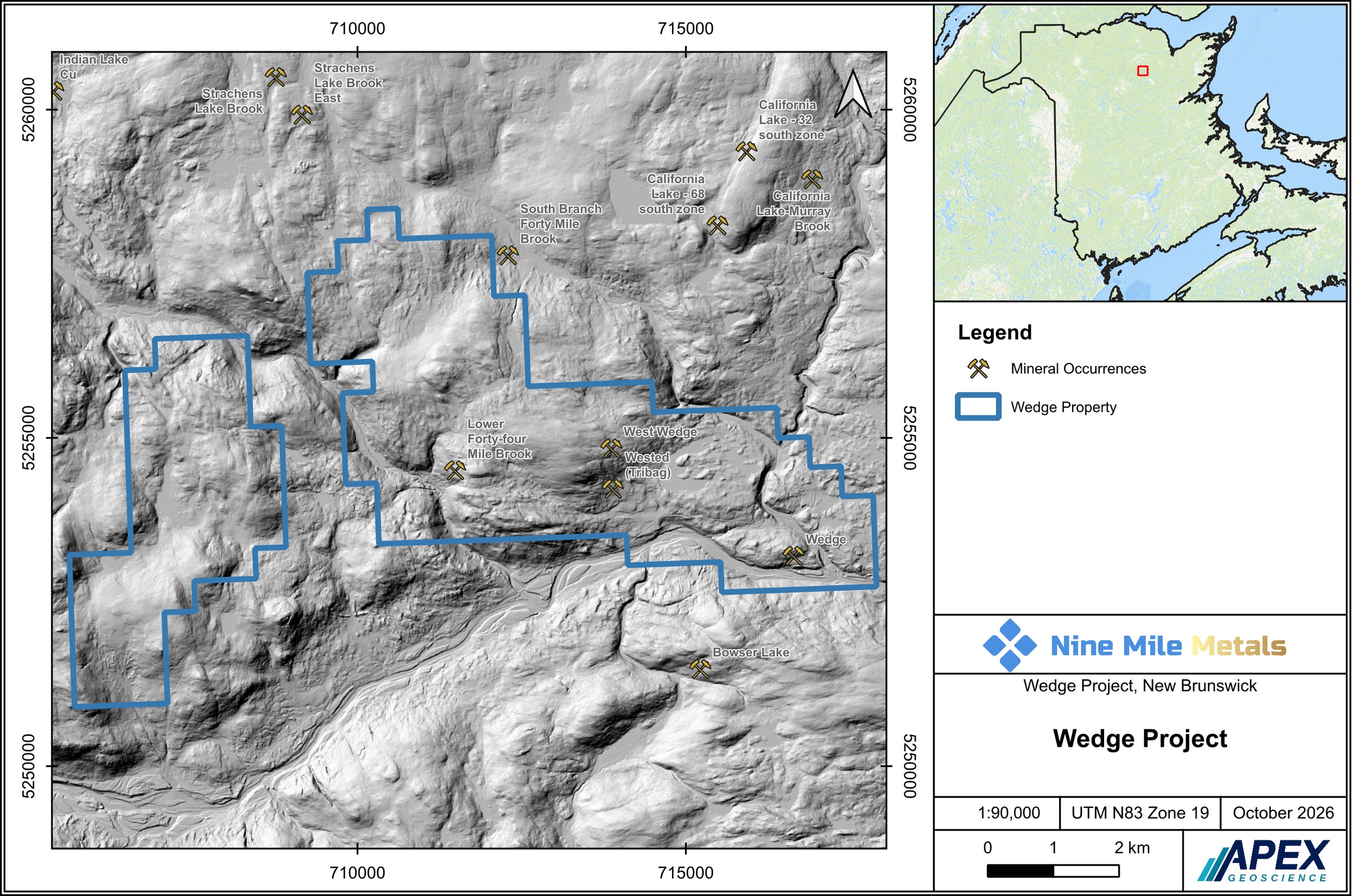

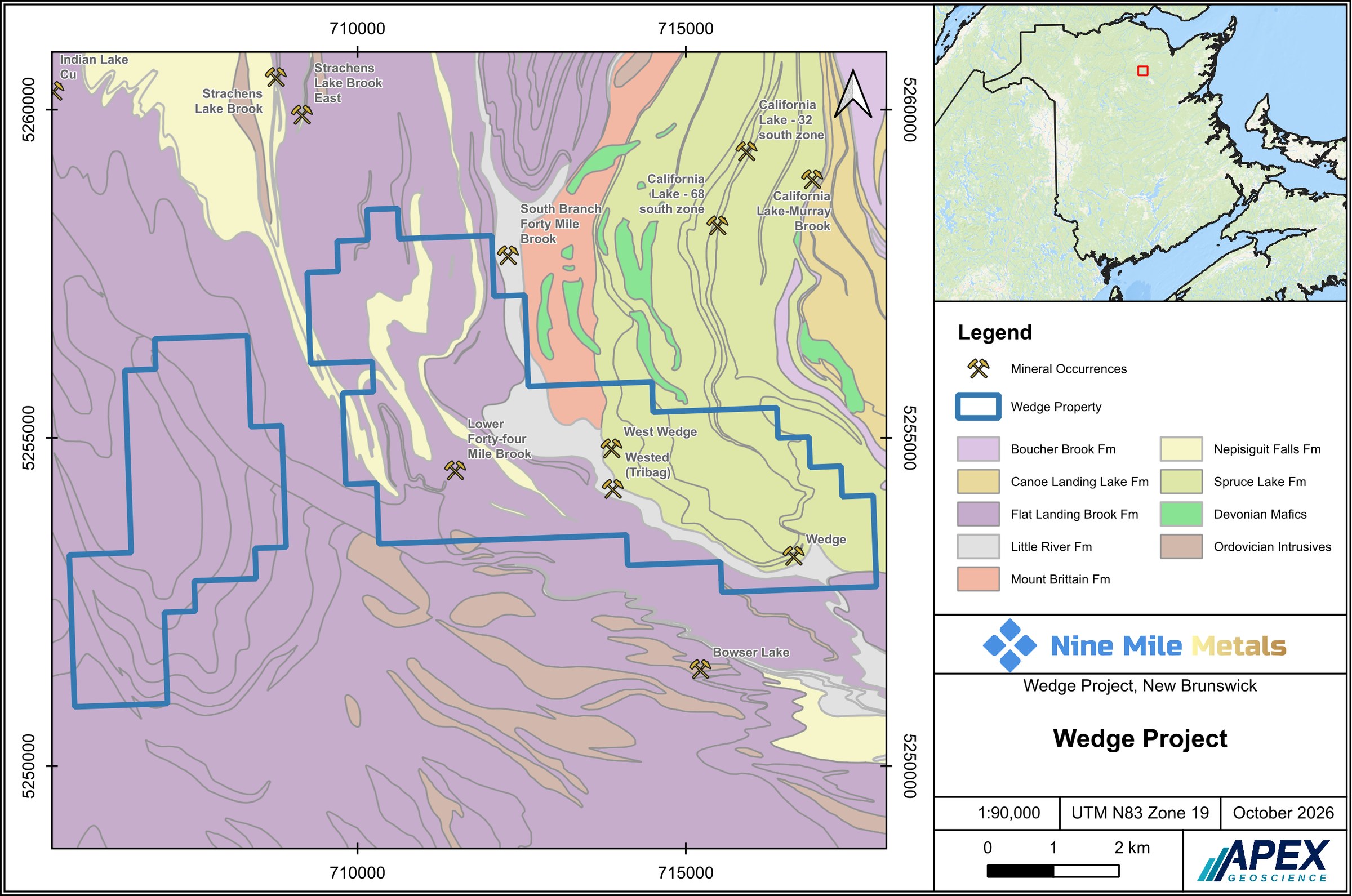

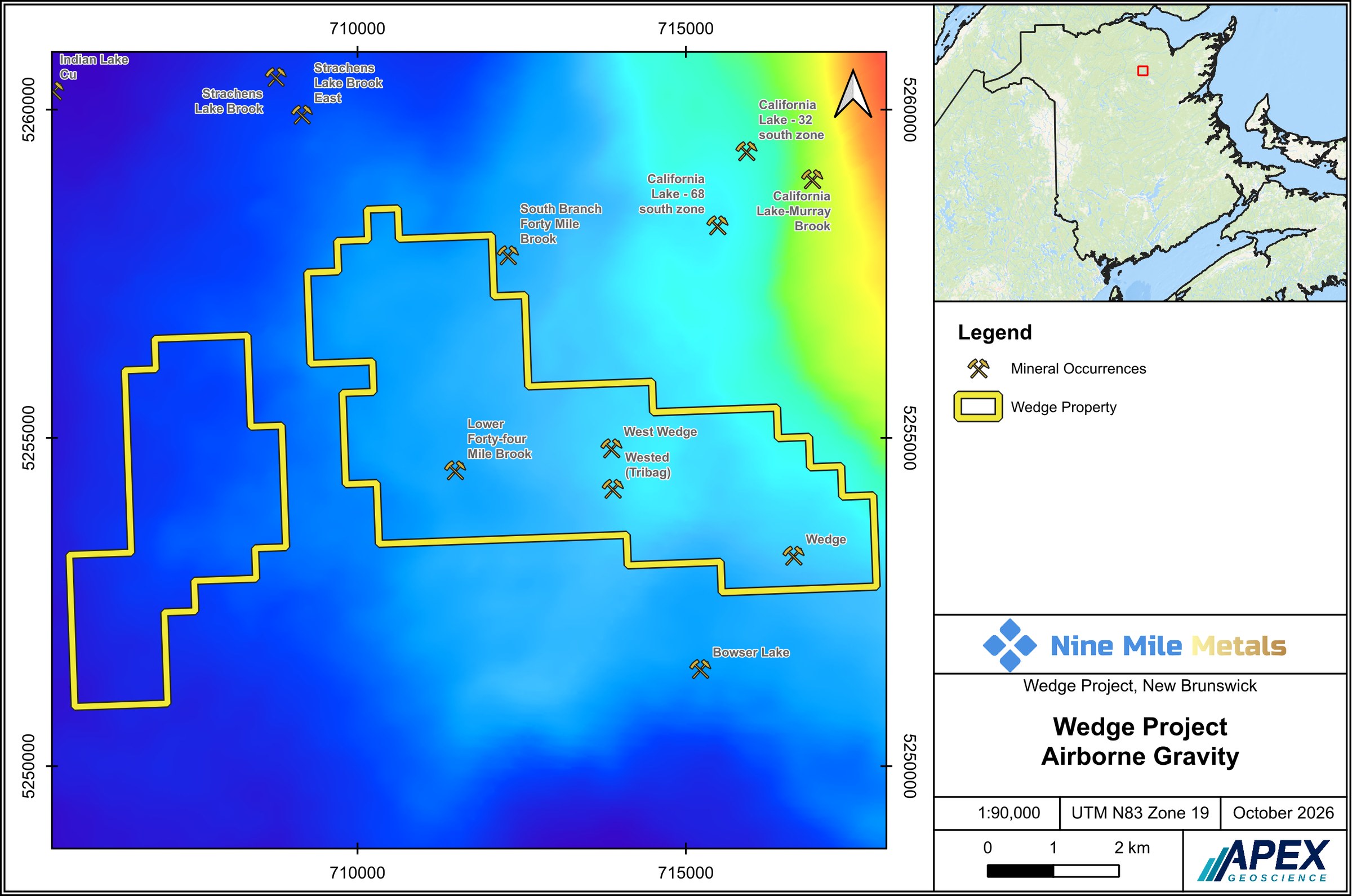

Maps

Click images above to enlarge

Junior Mining Hub Interactive Map

Junior Mining Hub is the ultimate destination for all Junior Mining News and information.

Technical Notes

Notes on Drill Results

Intervals are drilled core lengths unless stated otherwise. True widths were reported for WD-25-01 (22.65 m), WD-25-02 (Horizons 1–3), WD-25-2B, WD-25-05, WD-26-09, WD-26-10, WD-26-11 and WD-26-14. Remaining Phase 3 assays are pending at ALS Global.

Copper Equivalent

Copper equivalent values are for comparison only and are not directly comparable between holes; each is calculated on the metal prices and recovery assumptions disclosed in its own news release, which differ by release.

Hole / GroupPricing DateSourceRecovery
WD-24-0423 April 2024—80%
2024 Wedge holes13 May 2024—80%
WD-25-0213 February 2026—80%
WD-25-016 March 2026—80%
WD-25-2B1 April 2026—80%
WD-25-04 and WD-25-051 May 2026Kitco80%
WD-26-0911 August 2026Bloomberg95%
WD-26-0715 August 2026Bloomberg95%
WD-26-1026 August 2026Kitco95%
WD-26-11 and WD-26-1426 August 2026Kitco95%

No CuEq was reported for WD-24-01 (main zone) or WD-24-02.

Historical Information

Cominco production figures for the Wedge — approximately 1.5 Mt at 2.88% Cu, mined 1962–1968 — are historical, are sourced to McCutcheon et al. (2005), predate National Instrument 43-101, have not been verified by a Qualified Person, and are not current mineral resources or mineral reserves. Historic camp production tonnages and grades are sourced to McCutcheon, S.R. and Walker, J.A. (2020), Geoscience Canada, v.47(3), Table 1, published by the Geological Association of Canada.

No Mineral Resource

No mineral resource or mineral reserve has been estimated on any Nine Mile Metals property to date. A mineral resource estimate for the Wedge is in progress; there is no assurance that it will be completed or that it will support a mineral resource. Geophysical targets shown are conceptual, are derived from modelling, and are not mineral resources.

QA/QC and Sample Security

Samples are analyzed by ALS Global, Moncton, New Brunswick, an accredited laboratory independent of the Company. Base metals by ME-ICP61a four-acid digestion with ICP-AES; gold by fire assay Au-AA23 with AA finish; overlimit gold by gravimetric analysis and overlimit base metals by OG62. ALS runs its own QA/QC protocols including coarse and pulp duplicates. The Company inserts certified reference materials, duplicates and blanks with review of all results; QA/QC and data validation were performed and no material errors were observed. WD-25-01 was assayed by Activation Laboratories Ltd. (Ancaster, Ontario), an accredited laboratory independent of the Company.

Qualified Person

The scientific and technical information on this website has been reviewed and approved by Gary Lohman, B.Sc., P.Geo., VP Exploration and Director, the Company’s Qualified Person under National Instrument 43-101. Mr. Lohman is not independent of the Company. The Qualified Person has verified the data underlying the technical information on this website, including sampling, analytical and test data.

District Ranking

References to the Bathurst Mining Camp as the third largest VMS camp in the world are based on published district tonnage comparisons, which rank the camp third at approximately 250 Mt. Source: Barrie, C.T. and Hannington, M.D., Classification of Volcanic-Associated Massive Sulfide Deposits Based on Host-Rock Composition, Reviews in Economic Geology. That comparison excludes districts in China and the former Soviet Union.
